Buying & Selection

215 kWh vs 261 kWh BESS: A Buyer’s Comparison

Compare 215 kWh and 261 kWh BESS through real third-party projects in Taiwan and the UK, then apply the lessons to HUA-X power, energy and connection data.

Third-party published configurations: Renwu solar-storage-charging uses the 100 kW / 215 kWh class; Quest Power mobile diagnostics use the 125 kW / 261 kWh class.

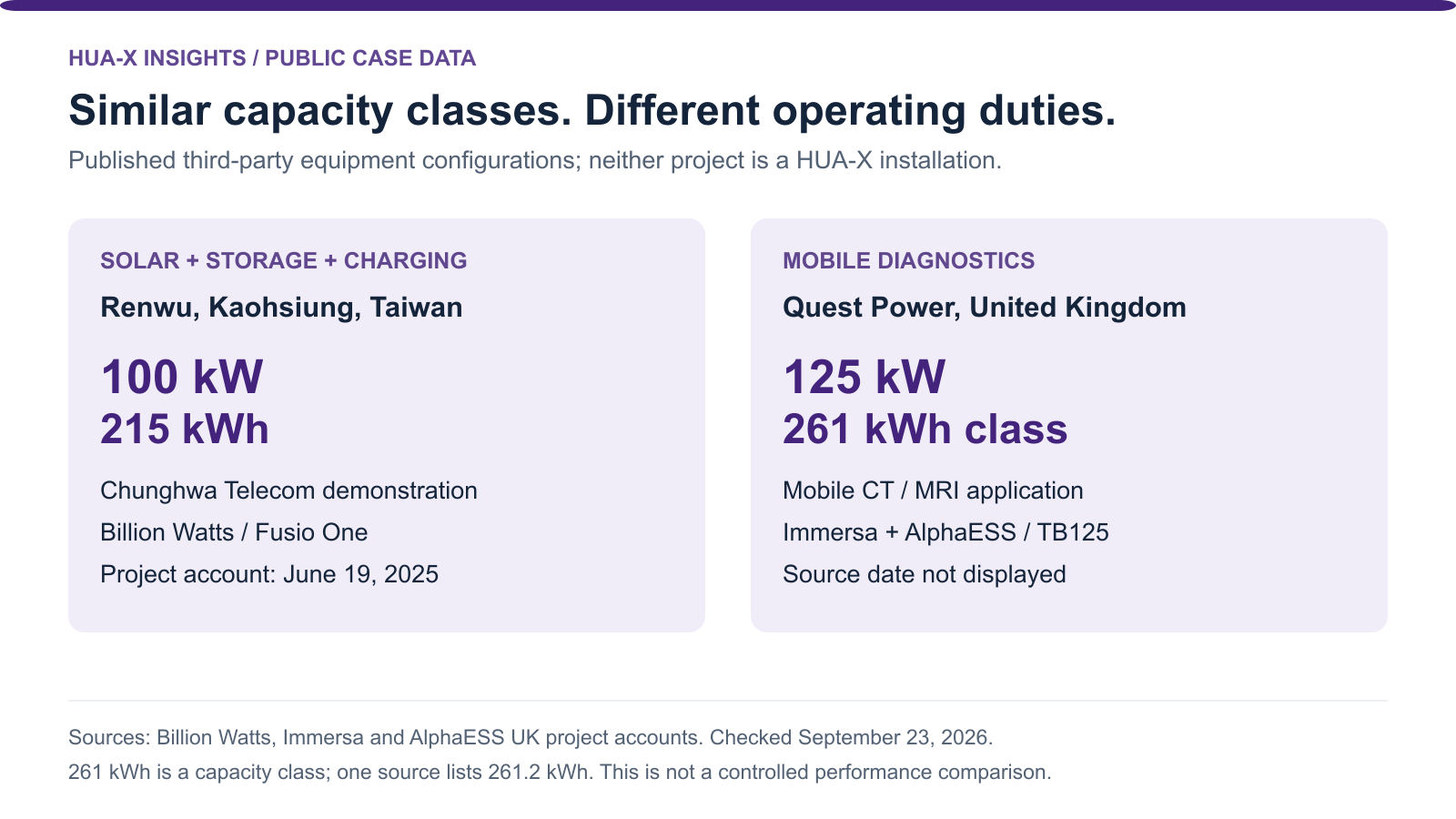

Figure 1. Original HUA-X editorial graphic from the Billion Watts, Immersa and AlphaESS project accounts [1–3], checked September 23, 2026. These are different third-party duties, not HUA-X installations or a controlled performance comparison. One TB125 source lists 261.2 kWh; the graphic uses the 261 kWh capacity class.

A 215 kWh versus 261 kWh BESS comparison becomes more useful when the numbers are attached to a real operating task. A solar-and-charging demonstration in Kaohsiung uses the 100 kW / 215 kWh class; a UK mobile-healthcare deployment uses the 125 kW / 261 kWh class. Their published project accounts show why energy capacity, power conversion and system integration need separate questions.

These are third-party projects reported by their suppliers, not HUA-X installations or a controlled comparison between two batteries. The case details below were checked on September 23, 2026. No invented load profile or assumed financial return is used.

Case 1: a 215 kWh system in a working solar-and-charging demonstration

In its June 19, 2025 project report, Billion Watts describes a completed demonstration at Chunghwa Telecom’s Renwu Training Institute in Kaohsiung, Taiwan. It identifies 103.24 kWp of solar PV, Fusio One 100 kW / 215 kWh storage equipment, and 7 kW AC and 120 kW DC chargers. The project combines these with an energy management system. The report describes using daytime solar and stored electricity at later times, but supplies no interval dispatch file or quantified bill reduction. Read the Billion Watts project account [1].

For a buyer, the instructive detail is the coexistence of several different ratings. Solar kWp, battery kWh, battery power in kW and charger output are not interchangeable. In particular, the 120 kW DC charger rating does not say that the 100 kW battery supplies the charger alone, continuously, or at full output. Establish the grid contribution, simultaneous loads and conversion boundary before transferring this configuration to another site.

This case suggests a practical first question for either cabinet size: what duty is the battery actually assigned within the whole system? Request the site single-line diagram and an operating sequence that shows the grid, solar, storage and controlled loads together. A list of equipment ratings cannot answer that question by itself.

Case 2: a 261 kWh-class system selected around mobile medical loads

Immersa’s public Quest Power case describes a UK mobile CT/MRI power project using AlphaESS TB125 systems, rated in that account at 125 kW / 261 kWh each, with 300 kVA static transfer switches. The account describes a developed and tested application, but displays no publication or commissioning date. Its configuration is supplier-reported information checked on September 23, 2026. Read Immersa’s project account [2].

AlphaESS UK separately describes application testing, control-software work and a battery-first operating strategy with generator charging controlled by state of charge. Its project summary lists 261.2 kWh per system, while the narrative uses 261 kWh. This article therefore uses “261 kWh class” for that third-party equipment. Neither source publishes a quantified fuel-saving result with a measurement period. Read the AlphaESS technical case account [3].

The purchasing lesson is that an energy-capacity increase cannot substitute for proving the operating mode. Ask how the proposed system handles load changes, transfers between sources, restarts after a stop and recharges before the next duty period. Where a transfer switch or generator is involved, identify its role and rating separately from battery-inverter output. The 300 kVA switch in this case does not turn a 125 kW battery inverter into a 300 kW source.

What the two cases support—and what they do not

Table 1. Two different supplier-reported projects, checked September 23, 2026. The ratings are equipment descriptions, not measured usable AC energy. These cases do not establish comparative efficiency, price, runtime or savings. Sources: the linked Billion Watts, Immersa and AlphaESS project accounts above.
Procurement questionKaohsiung demonstrationUK mobile-healthcare deployment
Public equipment classFusio One, 100 kW / 215 kWhTB125, 125 kW / 261 kWh class
Published system contextSolar, storage, EV charging and EMSBattery, static transfer switch and generator integration
Useful follow-upWhich source serves each coincident load?Which operating transitions were tested?
Evidence needed before copying the designMeter-boundary load and generation records; connection designLoad-response and transfer acceptance records; recharge schedule

The evidence supports two concrete procurement approaches. For an energy-management project, reconcile the cabinet with the other sources and loads. For an off-grid or backup requirement, obtain proof of the complete operating sequence. Neither approach can be replaced by selecting the larger kWh label.

Apply those lessons to the HUA-X 215 kWh and PowerFac-261 options

The third-party installations demonstrate questions to ask; they do not validate HUA-X equipment in those applications. For the two HUA-X configurations, start with the published product records:

Table 2. HUA-X published model data, checked September 23, 2026. This is a nameplate and interface comparison, not a site acceptance result. Sources: 100 kW / 215 kWh product record [4] and PowerFac-261 product record and procurement brief [5]. The underlying PowerFac-261 brochure has no printed revision or issue date.
Published HUA-X field100 kW / 215 kWh cabinetPowerFac-261
Rated power100 kW125 kW; output derating above 45 °C is stated in the brochure
Nominal battery energy215 kWh261 kWh
Battery-side nominal voltage768 V DC832 V DC
Published AC connectionNot established by the fields used here400 V, 3W + N + PE; 50/60 Hz
Cabinet enclosureIP54IP54; IP65 applies separately to battery packs
Separate comparisons: rated power increases from 100 to 125 kW; nominal battery energy increases from 215 to 261 kWh

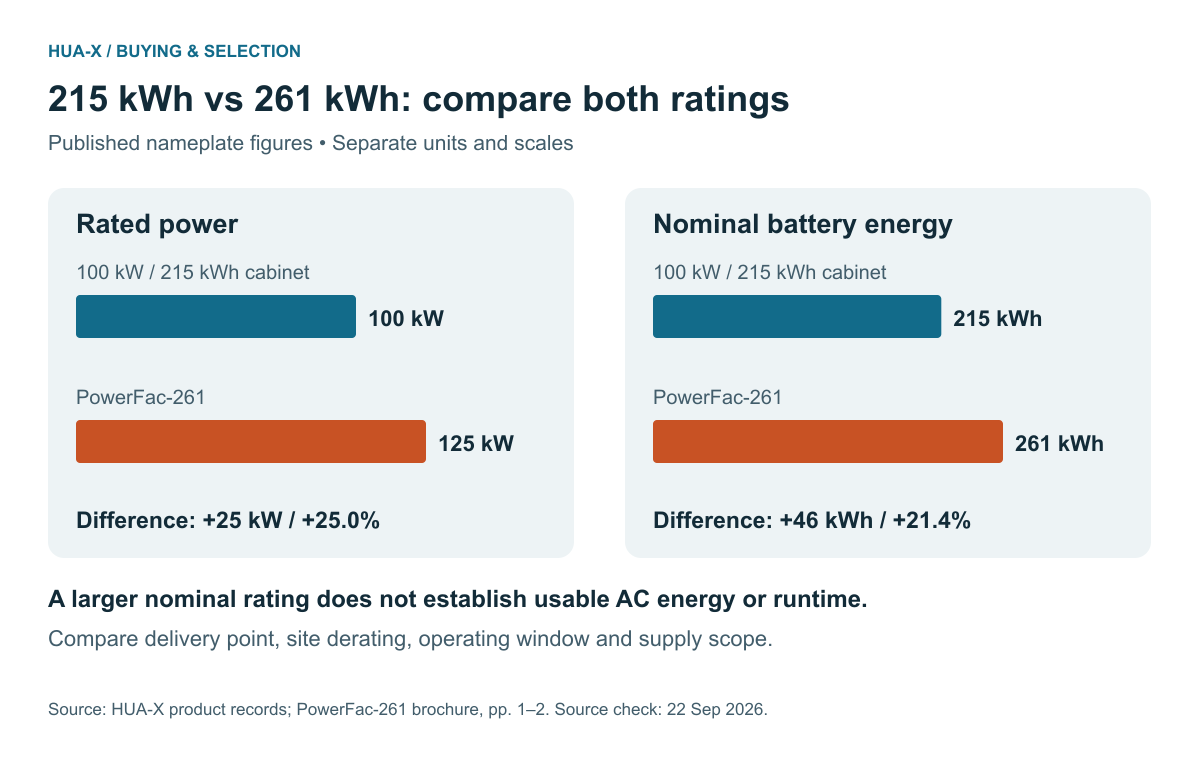

Figure 2. Published HUA-X nameplate ratings [4–5], shown on separate power and nominal-energy scales. The 25% power difference and approximately 21.4% energy difference are arithmetic comparisons, not measured runtime or savings. The third-party case installations above do not validate either HUA-X model.

The two ratings rise by different proportions. Dividing nominal kWh by rated kW gives approximately 2.15 hours for 215/100 and 2.09 hours for 261/125. This is a nameplate energy-to-power ratio only: it excludes the operating window, losses, auxiliaries and site conditions. It cannot establish how long either cabinet will supply a real load. Use the nominal versus usable energy guide [6] when requesting a delivery-point energy statement.

The connection review also remains model-specific. The battery-side DC voltages are not utility connection voltages. PowerFac-261’s 400 V and 50/60 Hz listing does not establish compatibility or approval for a US installation. Request the exact configuration, required external equipment and applicable model-specific compliance documents for the actual country and site.

Turn a case study into a comparable request for quotation

Send both suppliers the same interval load and generation files, electrical connection, installation conditions and operating objective. Ask for three concrete outputs:

  • A power-and-energy duty statement at an agreed measurement point, including usable energy, reserves, auxiliaries and derating.
  • A system boundary identifying supplied and external equipment, controls, installation and commissioning responsibilities.
  • An acceptance plan for the required operating modes, with any unsupported duty or unresolved interface clearly listed.

Treat public case studies as evidence of what their named project teams reported. Use the quotation and acceptance process to establish what will be delivered at your site. The BESS RFQ checklist [7] covers the wider request, and you can request PowerFac-261 documents [8] while identifying the 215 kWh alternative in your project brief.
